Judy - Harbour Energy

Harbour Energy seeks permit to develop North Sea field as subsea tie-back

Authorities & Government

UK oil and gas company Harbour Energy has filed its environmental statement with the UK authorities for the development of the Talbot field located in the North Sea.

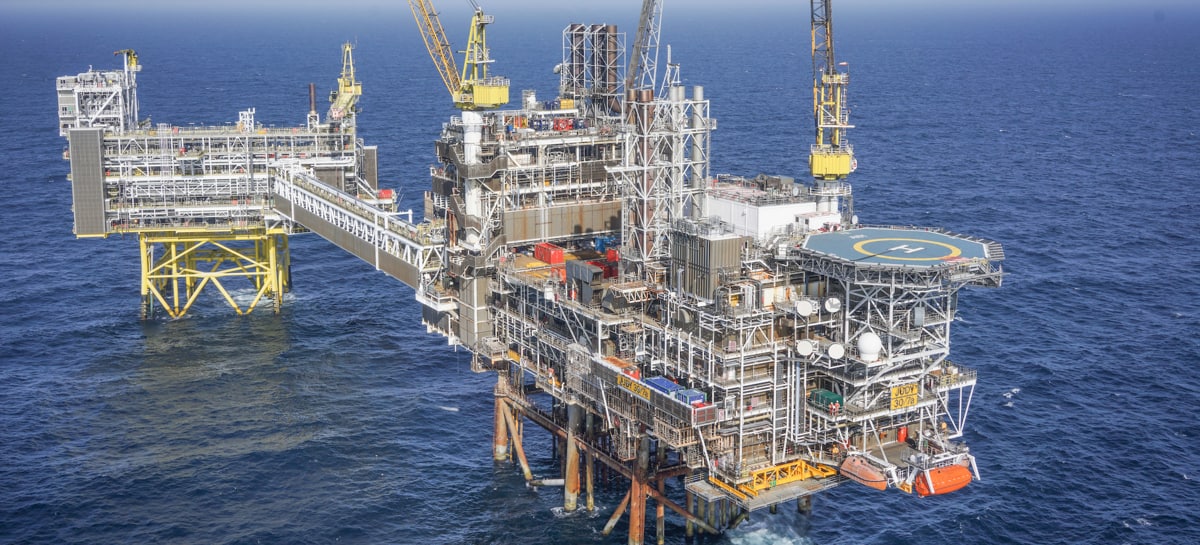

Judy platform; Source: Harbour Energy

An application for consent was submitted by Harbour Energy to the North Sea Transition Authority (NSTA) for the Talbot field development project on 27 May 2022. This was accompanied by a copy of the Environmental Statement (ES) for the field development.

The Talbot development project is a discovered light-oil and associated gas resource opportunity. The primary nature of this project will be for a multi-well subsea tie-back of the Talbot field to the Judy platform and the subsequent export of produced hydrocarbons to Teesside, UK.

The Talbot project is located in the central North Sea in block 30/13e of the UKCS. The Judy platform is located in 30/07a of the UKCS. The Talbot production flowline, which connects the Talbot field to the Judy platform crosses blocks 30/13e, 30/12a and 30/07a of the UKCS. The water depth of the location is a maximum of 75.4 meters.

As part of the project, three development wells will be drilled within a four-slot subsea drilling template with three subsea production systems installed within the drilling template. A four-slot subsea manifold will be installed using spools to connect the three subsea production systems.

The Talbot subsea manifold will be tied back to the existing Judy infrastructure via a subsea multiphase pipe-in-pipe production flowline and umbilical with an approximate length of 16 km. The umbilical will provide power, communications, hydraulic supply, methanol and other chemicals from the Judy platform to the Talbot subsea facilities.

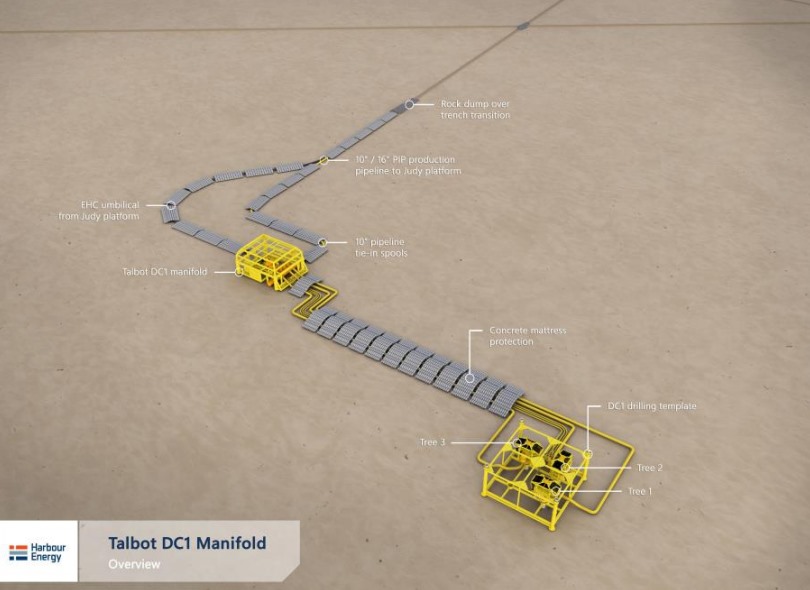

Talbot DC1 manifold - Harbour Energy
Talbot DC1 manifold; Source: Harbour Energy

The Talbot production flowline will tie in to the existing Joanne South 12” production pipeline (PL1000) at a point upstream of the Judy platform. Talbot produced fluids will comingle with Joanne and Judy field fluids on the Judy topsides, prior to entering the Judy-Joanne high-pressure production separator for onward processing on the Judy platform.

At Judy, Talbot produced fluids will be separated into gas and liquids streams and commingled with other J-Block area fields’ (Jade, Jasmine, Joanne and Judy) production.

Talbot gas will be transported as part of a commingled stream from the Judy platform, via the 20” gas export line PL977, to the CATS pipeline system and thereon to Teesside, UK for processing. Talbot liquids will be sent, via the 24” oil export line PL978, to the Norpipe liquids pipeline and thereon to the Norsea terminal at Teesside for processing.

Talbot timeline

According to Harbour’s plans, development drilling will be conducted from 4Q 2022 or potentially in 3Q and subsea infrastructure and pipelines will be laid in 2023/2024. The first oil from the project is expected in 3Q 2024.

Earlier this year, Harbour Energy started production from its delayed project in the UK sector of the North Sea, the Tolmount gas field, which is expected to increase domestic output by over 5 per cent once it reaches plateau levels.
